Progress

Latest Updates

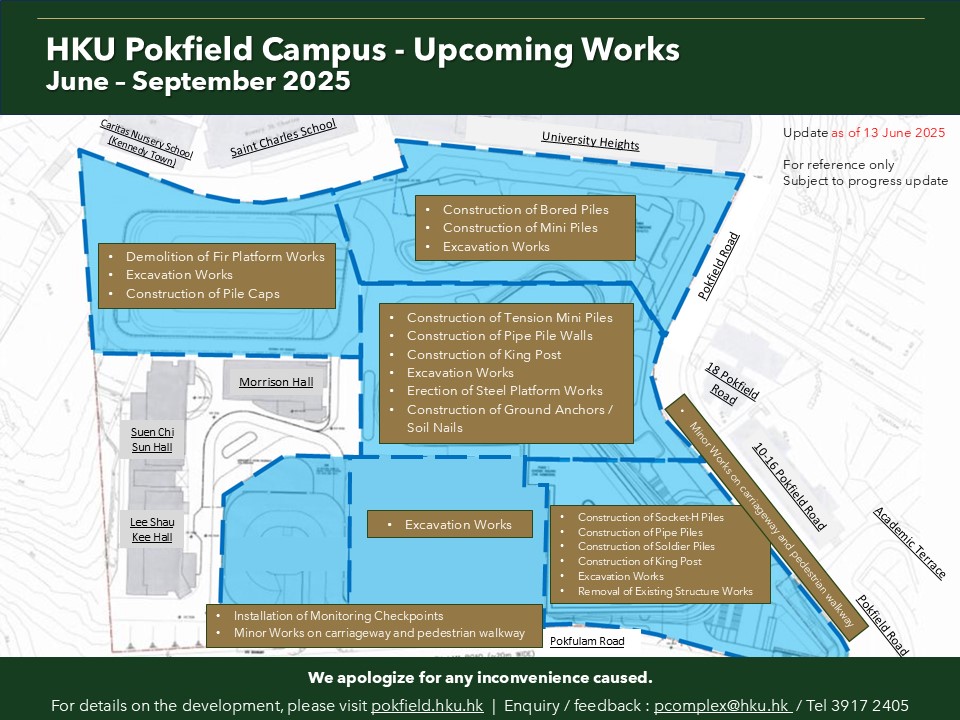

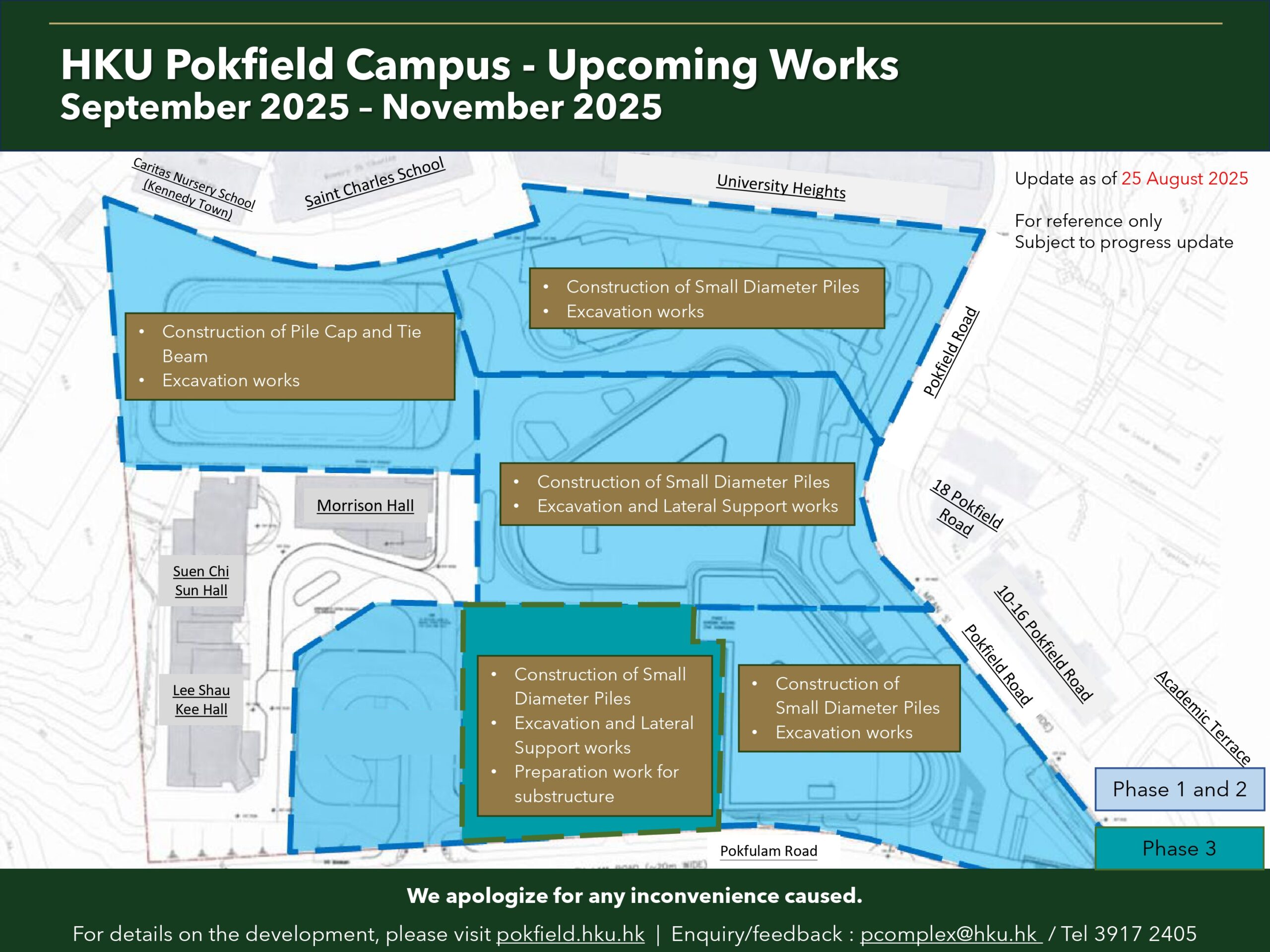

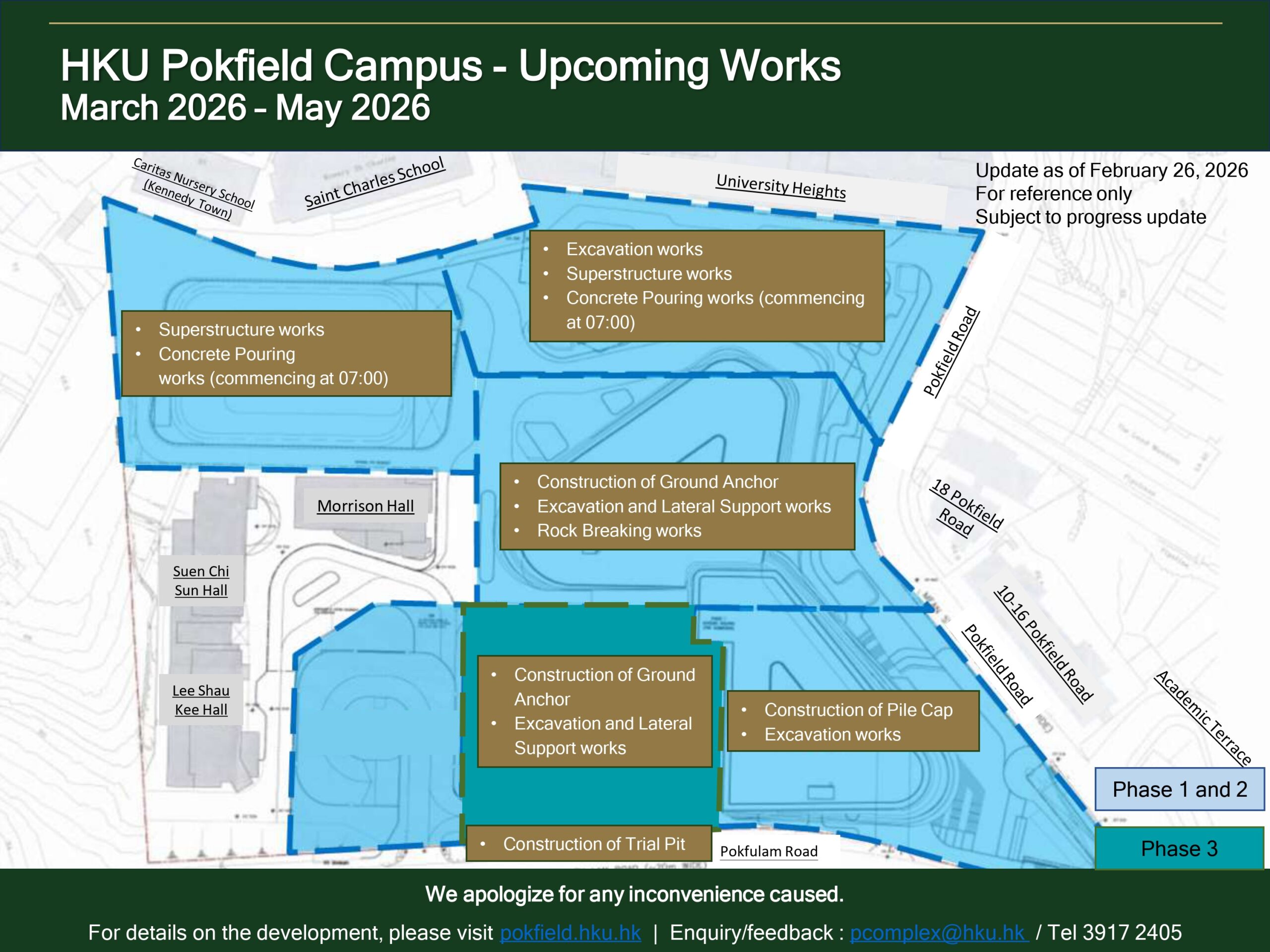

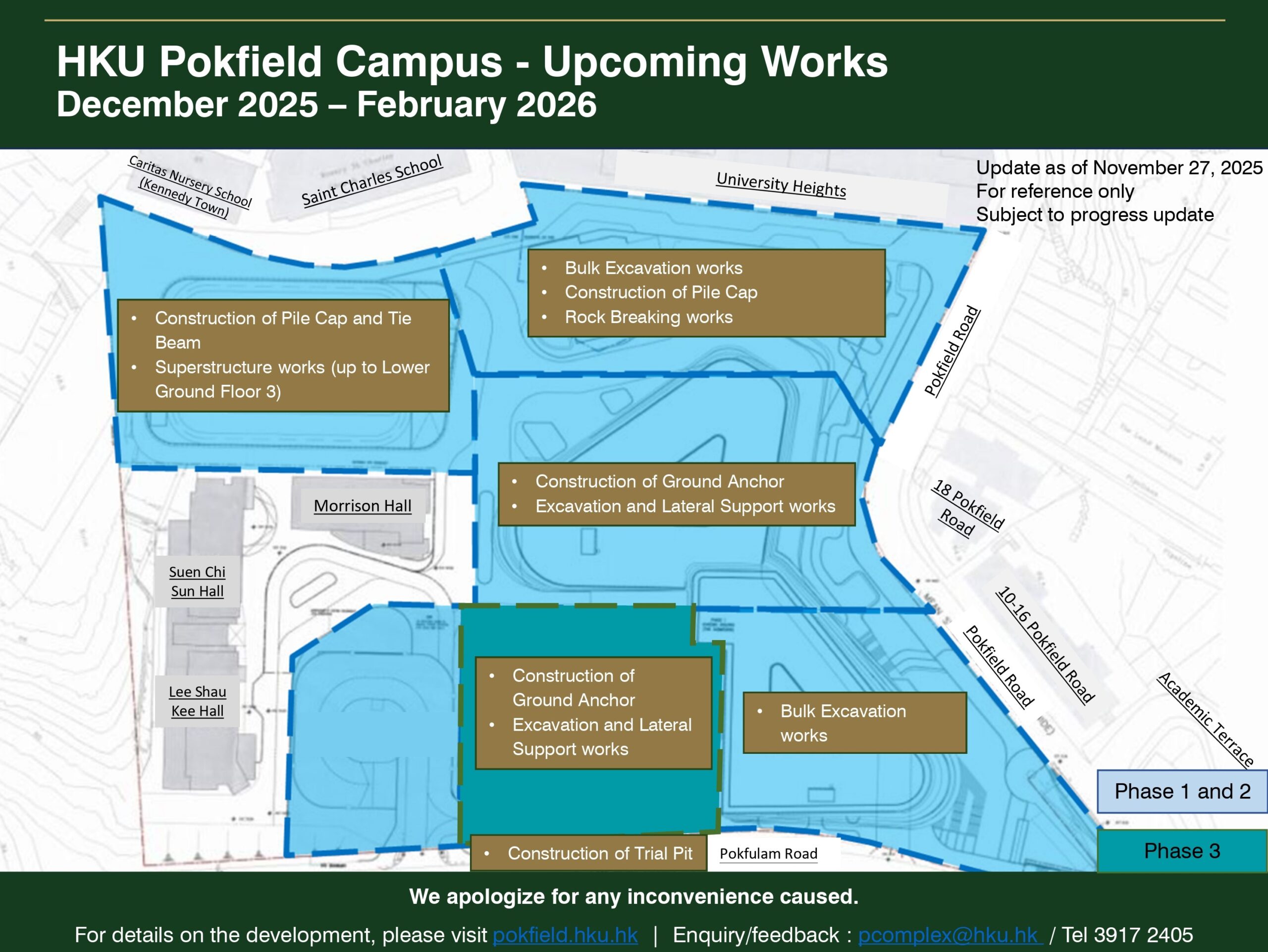

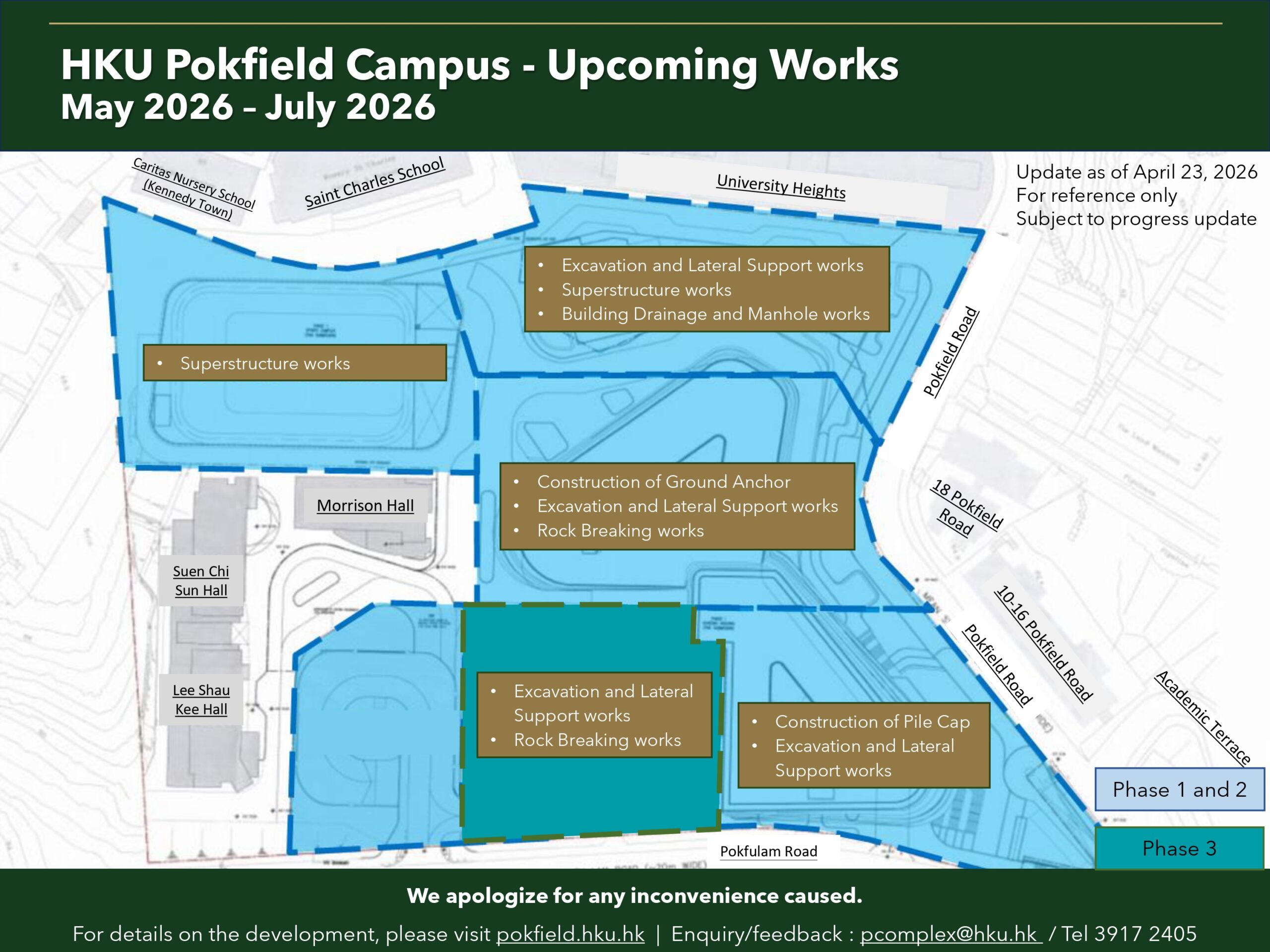

For the upcoming works at the Pokfield Road / Pokfulam Road site from October to December 2024, please click here for more details.

Important Notice

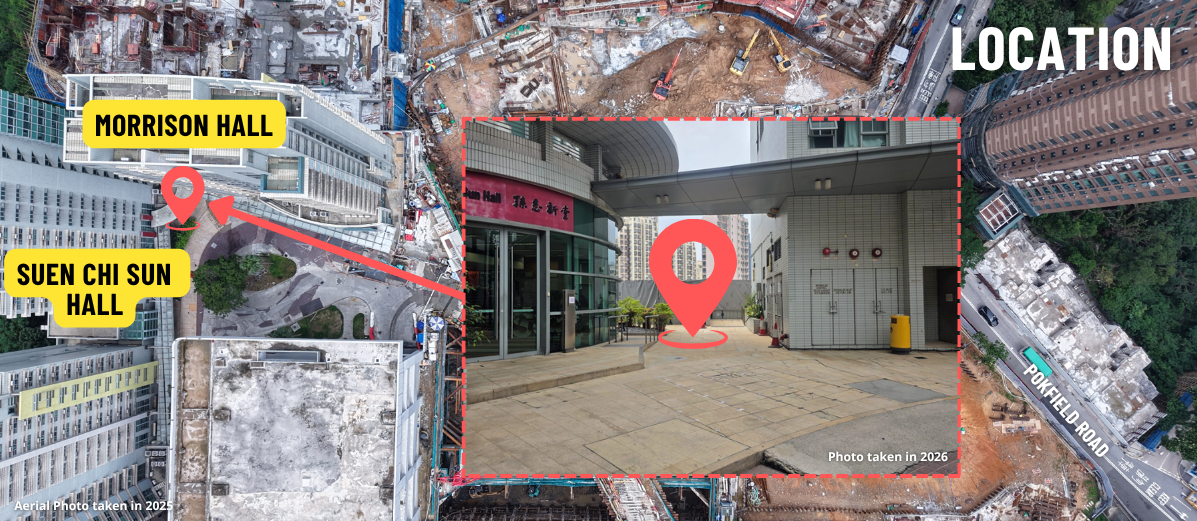

Vehicular and pedestrian access to Jockey Club Student Village II (Morrison Hall, Suen Chi Sun Hall, Lee Shau Kee Hall) from Pok Fu Lam Road is now re-routed via the new Drum Ramp Building. The existing access road has been closed and become a part of the construction site.



Pedestrians please follow the notices for the Pedestrian Path via staircase and elevator to/from Pok Ful Lam Road. An additional temporary designated path will be provided for pedestrian use during busy/night hours (8:00 am – 8:30 am; 7:00 pm – 7:00 am the next day).



Traffic Wardens will be stationed at the vehicular entrances to ensure traffic safety.

Milestones & Progress Logs

Q2 2020
Appointment of Consultants
Lead architectural consultancy engagement

Lead architectural consultancy engagement

Q3 2020
Project Design
exhibition
Design stage
Q4 2020 ~ Q1 2021
Advance Works
Demolition & Substructure Works at Pokfield Road Site
January 26, 2021
Advance Works

Groundbreaking Ceremony

March 2021~ June 2022
Advance Works
Demolition & Substructure Works at Pokfield Road Site
July 2021
Submission of Planning Application
Phase 3 buildings for Pokfield Campus Development
Submission of Planning Application on Pokfield Campus Phase 3 Academic Building
May 2022
Town Planning Board (TPB)'s approval
Phase 3 buildings for Pokfield Campus Development
The Planning Application on Pokfield Campus Phase 3 Academic Building received TPB's approval
2025 ~ 2027
Substructure & Superstructure Works

Completion in three phases

(subject to the construction schedule and statutory procedures)
